Current Construction Schedule/Updates

As of September 2009, the Buckman Direct Diversion (BDD) Project was on schedule, according to the BDD Contractor. Future anticipated milestones include:

  • Completion of river diversion structure – May 2010
  • Completion of construction and systems testing – December 2010
  • Completion of staffing – December 2010
  • Acceptance testing – Probably April 2011
  • Operations and Management turned over to City of Santa Fe staff – May 2011



Check the map and description below for details on construction activities planned for the fall and winter of 2009.

Download construction flyer

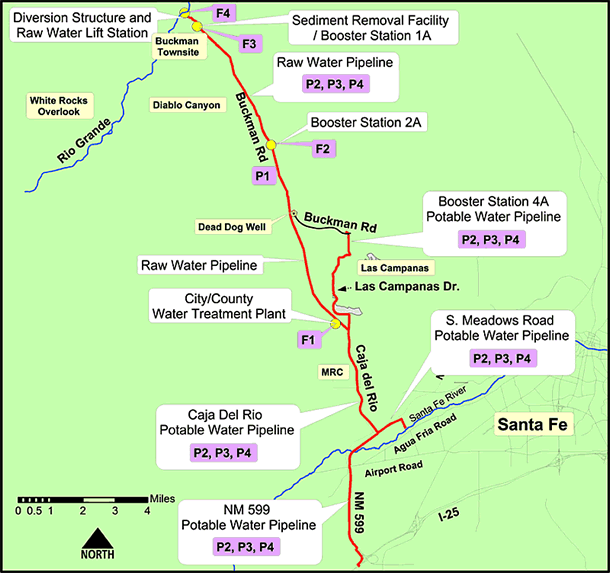

contsruction map

Planned Construction Phases (weather permitting) for the BDD Project – September through December 2009*:

P1 – PNM crews will continue installing new power feeders along the entire Buckman Road Corridor (expected through October 2009).

P2 – Crews will continue restoring and revegetating areas where pipelines have been completed (See front page.)

P3 – Crews will continue installing pipeline-related accessories along the new pipelines.

P4 – Crews will continue testing pipelines for leaks. Water may be discharged to arroyos if necessary.

F1 – Crews will continue working on the Water Treatment Plant (expected through February 2011).

F2 – Crews will continue working on Booster Station 2A. Expect local area congestion for deliveries, off-loading, and general material handling in this area.

F3 – Crews will continue working on the Sediment Removal Facility / Booster Station 1A. Expect local area congestion for deliveries, off-loading, and general material handling in this area.

F4 – Crews will continue working on the Diversion Structure and Raw Water Lift Station. Construction activities impede normal river access in the area near the construction site, which is fenced and off-limits to the public. Vehicle traffic is temporarily re-routed, and access to the river is available both upstream and downstream of the construction site. Expect local area congestion for deliveries, off-loading, and general material handling in this area.

* Construction dates are approximate and may vary due to unexpected circumstances or weather conditions.



In general, construction crews will work from 7 a.m.-7 p.m. Monday-Friday, although longer work hours or weekend work may be required on occasion for emergencies or in response to weather conditions. For more information, contact Barbara Crockett or (505) 239-4772 or Patti Watson or 1-800-687-3417, ext. 3134.
